Three Rivers Stadium Implosion:
Preparation and Results

(Click on each small thumbnail picture
to see the enlarged version)

Longrangeext_small.jpg (1582 bytes) Newandold.3.jpg (39982 bytes) Debris1a.jpg (40815 bytes) Drilling.jpg (37433 bytes)

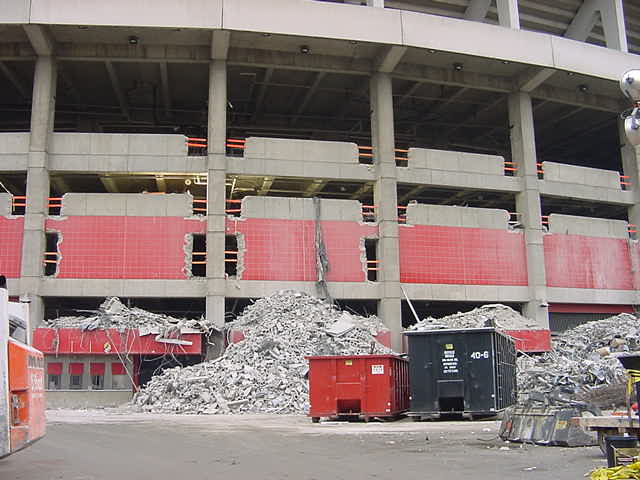

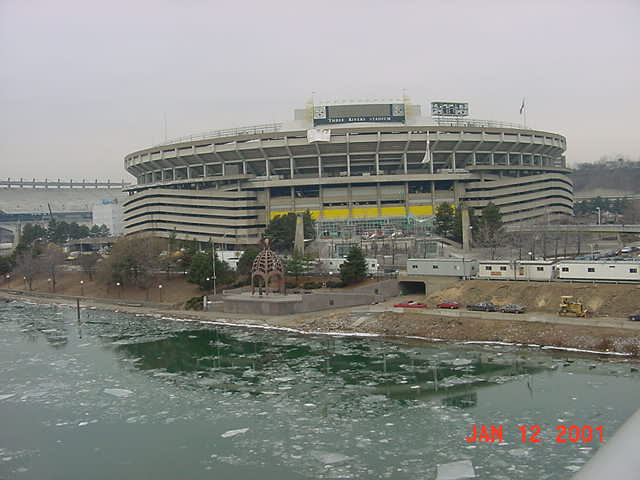

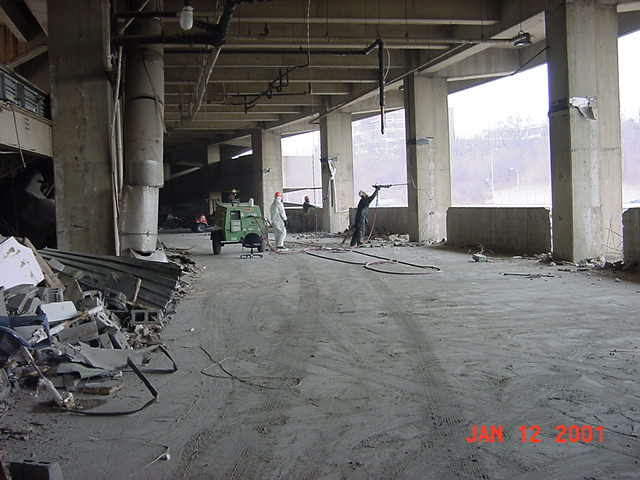

Three Rivers Stadium on the banks of the Ohio River on a cold January morning.  In a little less than a month, it would make way for a new Steeler’s stadium. The new Steeler’s stadium, not yet named, presented numerous problems for Controlled Demolition, Inc. of Baltimore, Md. because it sits than 65 feet from Three Rivers.  The closest sections of the new stadium, constructed mostly of glass, required that the demolition be controlled so that flying debris (flyrock) would not reach it. Work to weaken the structure involved removing all non-load bearing walls.  All of the 800 columns on the 5 levels of the stadium were entirely exposed so that they could be wrapped with 2 layers of chain link fence and a spun geo-textile material.   The enormous piles of debris inside and outside of the stadium had to be removed before any work with the explosives could begin. Horizontal drilling of the columns was begun immediately. The condensed time schedule required by the upcoming baseball and football seasons, required that the demolition contractor sometimes operate these drills around the clock.

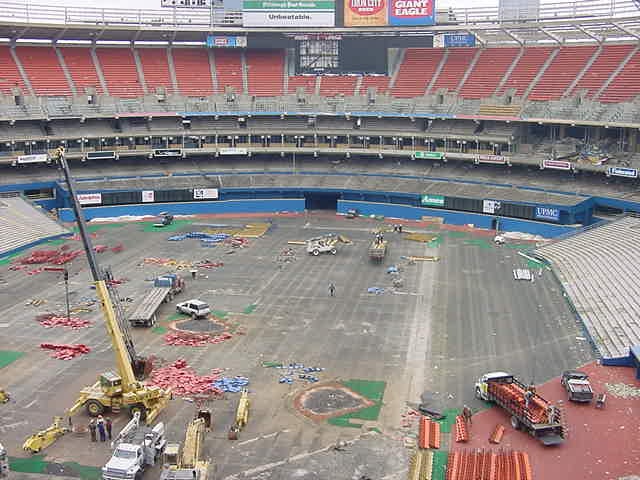

CDImeeting.jpg (37179 bytes) Interior4.jpg (38531 bytes) Exterior.jpg (39536 bytes) Exparrival2.jpg (39328 bytes)

With the work inside the stadium continuing, numerous meetings outside with the Pittsburgh Sports and Exhibition Authority, DEP, the Pittsburgh Department of Public Works, and other associated agencies are held.  This meeting with CDI and DEP Explosives Inspectors insures a safe delivery and storage of dynamite at the site. Approximately 10,000 stadium seats that were not sold at the public auction of Three Rivers memorabilia had to be removed as the stadium was further prepared.   The bleachers on the field were removed and piled in the center of the stadium floor. This photo shows the columns near Gate B wrapped and ready for loading of the explosives. This scene was repeated around the entire stadium  until all columns were readied. On February 5, explosives were brought into the site for a test blast.Twelve columns of different size and construction were loaded with carefully measured amounts of explosives to demonstrate how each column would be affected by the test blast.
Magopen.jpg (37008 bytes) Stickinhand.jpg (37058 bytes) stemming.jpg (38431 bytes) Markstick.jpg (37097 bytes)

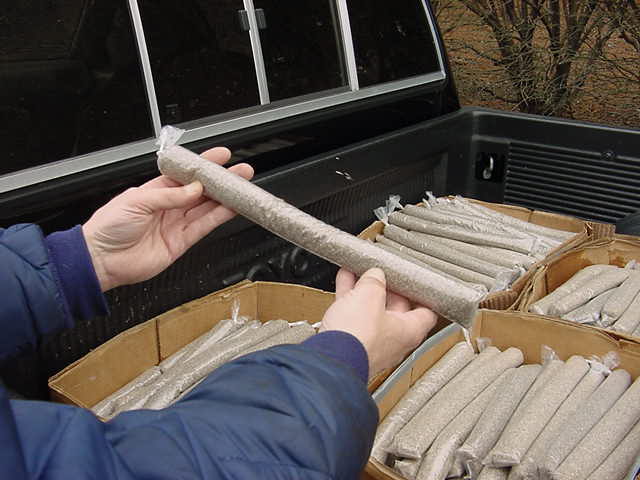

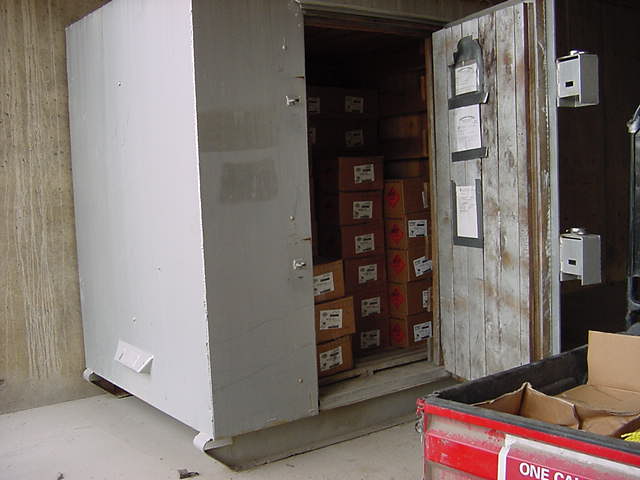

The explosive magazine shown here provided safe storage of approximately 4500 pounds of explosives and 2800 detonating caps. Each ¾ pound stick of Austin Powder’s EX Gel was placed in the drilled column and then stemmed with sand. The sand was prepared at CDI’s Offices in Baltimore, Maryland and transported to Pittsburgh.  Each 1 inch tube shown here was placed over the explosive to concentrate the energy in the column. Doug and Mark Loizeaux carefully place the explosive and stemming in each hole for the test blast.
LoadingTV.jpg (40421 bytes) 1836done.jpg (38671 bytes) Loadedcolumns.jpg (36534 bytes) Tugtstadiums.jpg (38602 bytes)

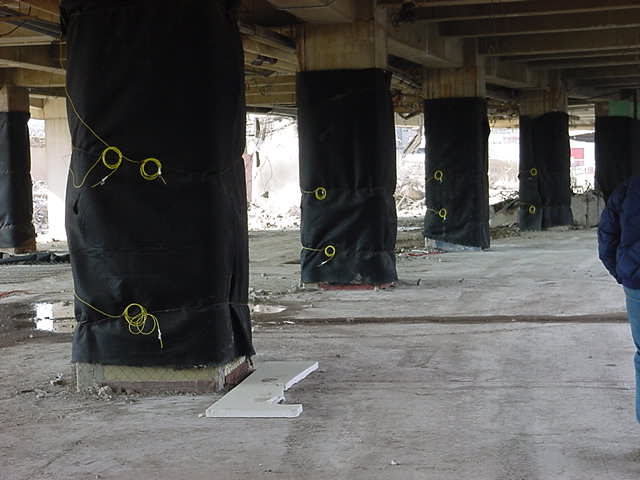

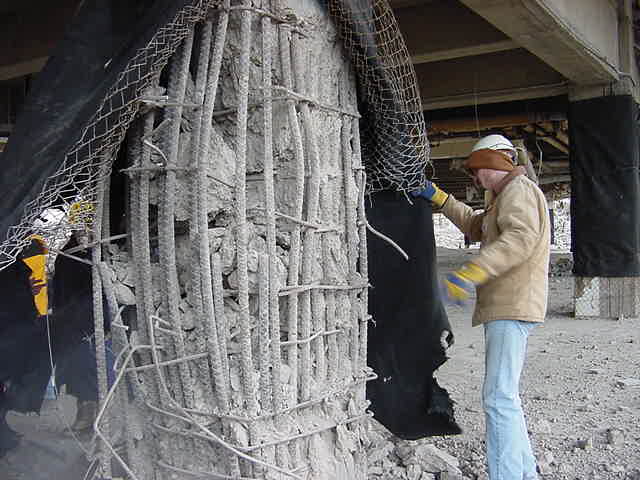

A camera crew from CBS documents the loading procedure for their special on the implosion of Three Rivers Implosion. The columns pictured show the effects of the test blast. The blast caused the rebar within the column to vibrate and bend outwards allowing the concrete to pulverize. From the test blast, the blasters learned the proper amount of explosive to use for the specific type of column.  All columns can then be loaded and wired for the implosion.   These columns are ready to be hooked together. This view from Mt. Washington provides an excellent vantage point to watch the implosion.  Approximately 10,000 people chose this area to view the implosion.
MVC-011S.JPG (38449 bytes) MVC-008S.JPG (38433 bytes) MVC-014S.JPG (40121 bytes) MVC-010S.JPG (37869 bytes)

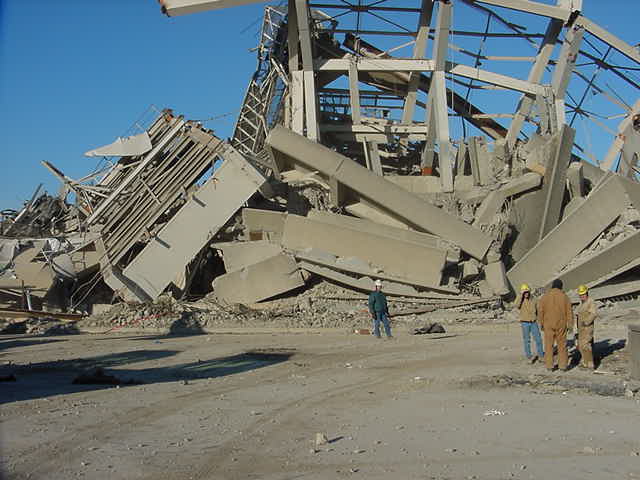

The implosion of Three Rivers occurred on Feb. 11, 2001 and produced minimal damage to the new stadium.  One broken window, shown covered here with a spun Geotextile material and a small chip of one of the concrete blocks on the new stadium was all that could be found. This picture of the steel rim around the top of the stadium, formerly at the 600 level, now rests on the 100 level after the blast.  The demolition contractor chose not to cut up this steel rim, but, rather remove it after the implosion. The enormity of the job of demolition and removal of the stadium is aided with explosives, but considerable work remains. This view of the two stadiums shows how close the two were together.  No debris from Three Rivers came closer than 40 feet to the new stadium.

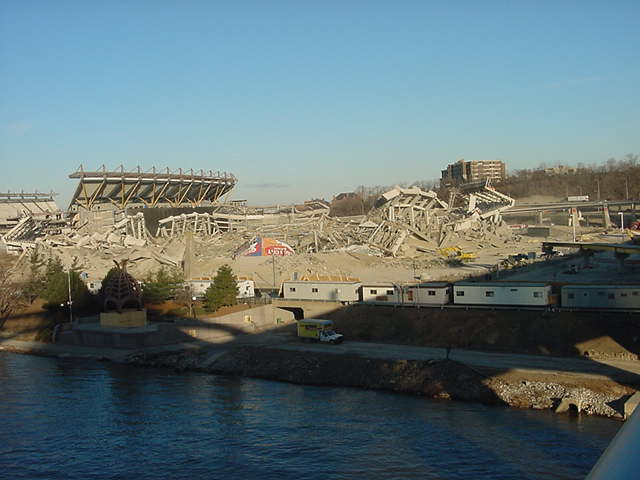

MVC-024S.JPG (35973 bytes) MVC-005S.JPG (37550 bytes) MVC-018S.JPG (34861 bytes) MVC-012S.JPG (40275 bytes)

The Goodyear blimp  hovers overhead to capture the implosion. The cable connecting the sections of the upper rim nearest the new stadium helped assure that the falling sections did not damage the new stadium. This view taken from nearly the same spot as the first picture in this sequence shows the success of the implosion. The overhanging rim, masked in dust, is highlighted against the city skyline. Mark and Doug Loizeaux congratulate each other for a job well done.  The explosive staff of the Greensburg District Mining Office concur.
